CPM is Broken – The WHY

I spend a lot of time thinking about project controls, it is my love and passion. Specifically in the planning world, P6 is weapon we are tasked with us. While I firmly believe the way in which P6 is used on projects needs to be expanded (extended) with the use of Agile (JIRA), nothing tops the user base and acceptance P6 has in our business.

P6 is fundamentally, just a CPM platform. We have activities and we have relationships (and constraints). It would seem simple to use at first; however, in practice, it is anything but simple and the way we build schedules is not helping matters.

What has specifically changed over the past 15-20 years is the DATA SOURCE from which we derive our data. 20years ago, we would run progress reports from P6 (we still do, but have complicated matters). Today there is much better visibility into deliverables on a project. What follows are some example from a construction project; however I feel as if the issue is more visible in the engineering and study side of things. Additionally, what has changed is the global adoption of EPR tools (Enterprise Progress Tools – aka Ecosys).

And that is the problem – we now have 2 or 3 sources of data that everyone looks at – and everyone thinks are integrated. Everyone has clear visibility into document progress by way of our document control tools, everyone has clear visibility into our EPR reports, and everyone struggles to understand what is in the schedule and why it is different. EPR is forcing document progress to drive overall reporting, but P6 does not track documents. We do not build schedules from a bottoms up document world. We (should) build schedules based on overall workflows. I will demonstrate this in many examples that follow and what we have been forced to do inside P6 to try to solve this conundrum, and exactly why our solutions all fail because we have fundamentally deviated from the CPM roots that used to make schedules valuable.

This is what a schedule is meant to look like

As Planned

In reality, below is what the schedule would look like today. Extended durations on everything, broken relationships, out of sequence work and worse than anything – NO CRITICAL PATH! This is not a good example – however I am confident you have dealt with a schedule like this and know this isn’t just an isolated issue anymore.

As Built

What is driving this insanity is the method (the data source) for where our progress comes from. The concept of what “site prep” meant in the original schedule was not the full site prep scope, but only the key site prep work required to commence the excavation.

What changed is the method and data source for where the progress is coming for our activities. Because we are not progressing the schedule, and instead are progressing an excel file to load into our EPR systems – to most likely drive a progress payment – the way data then flows into the schedule becomes meaningless.

There are many that would counter that we are simply running our progress system wrong, and that indeed the site prep should have been 100% earlier. And, likely true. In the above I am just being silly, but we have all seen this and we all know the issue.

So what is the solution?

The solution is to understand that when progress is measured outside the schedule and at a level that is at a finer level of detail than the schedule – the schedule becomes meaningless at certain levels. You therefore need to build schedules AT A HIGHER LEVEL.

The Correct Schedule

Instead of tracking the work at a lower level, for the schedule to bring back meaning, we need to only represent the high level workflows and leave the details in our progress system.

Keep your detail in Excel or you EPR System

The project should retain clear visibility to the detail and the detailed % complete; however, the detail items should not flow into the schedule because they can not be scheduled in a proper CPM way.

Again what is driving this is the method of progress no longer aligning with the methods of schedule. I understand this is severely controversial but when you start looking at your schedules these days and see countless in progress parallel activities that are simply being driven by interfaces with EPR systems to mirror a % – and not a proper schedule workflow – something is broken in our business. We would like to think our progress are all nice CPM logically driven schedules, and obviously I am not suggesting all our schedules are broken. However, the more I see issues such as this popping up in our As Builts Schedules, the more I want our industry to understand we are simply building crap schedules that are not agile enough to capture the intricate data now available in our other systems.

This article is only meant to better illustrate the problem – the why CPM is broken. Solutions (using CPM) are available. In the above I have actually suggested one solution, but several different models that can retain alignment with detailed progress items and retain a workflow CPM model are possible. Hopefully I will dive into those in subsequent discussions.

PowerBI Progress & Schedule Dashboard – By Darrin Kinney

I have recently been developing a series of videos that highlight the key features utilized in a progress and schedule dashboard. The videos showcase the capabilities of PowerBI dashboards in the Project Controls space. I have not seen dashboards effectively used in this way and want to share the valuable knowledge.

I have recently been developing a series of videos that highlight the key features utilized in a progress and schedule dashboard. The videos showcase the capabilities of PowerBI dashboards in the Project Controls space. I have not seen dashboards effectively used in this way and want to share the valuable knowledge.

This series is not meant to be a step by step guide. There are subtleties about this demo that may cause difficulties in the production environment. I would simply recommend you share this with your development team and discuss the pros and cons of your approach. Oftentimes, a more straight forward approach is more valuable when compared to endless development polishing an inferior product.

Part 1: The Showcase

This video gives an insight into the key capabilities of the dashboard. Having the ability to seamlessly review schedule activities, and how these contribute to the overall progress and forecast, is invaluable.

The ability to quickly dive into your schedule, without having to deal with the confines and limitations of your actual scheduling tool are also key features.

Part 2: The Excel Feeder Sheets

This highlights a simple Excel feeder sheet. Too often the time phased data that our schedules produce are not easily accessible in a digital format. I have built an excel file around a typical structure that project controls deals with. This structure will lend itself nicely to the steps that follow in converting the into a database format.

Part 3: PowerBI PowerQuery

Here we import the data from the Excel feeder sheets into the PowerBI platform. The use of PowerQuery is so embedded with the way PowerBI works. The steps you need to follow here are the similar to the steps you would need to follow in inserting the progress and schedule data into any formal data structure. The way we think about data is sometimes not compatible with the format that databases need. This is specifically around the need to “unpivot” time phased data.

Part 4:  PowerBI Measures and Dax

With all the data now structured and available to PowerBI, we need to now dive into the use of DAX to create Measures. A perfect example in the use of measures is in the generation of progress curves.

What might seem line a straight forward approach to drawing simple progress curves, is in fact (within the realms of PowerBI) not that simple. However, if you follow a logic approach and know what calculations are needed, the world is your oyster.

Part 5: Integration of JIRA and Agile Methods

In the (as of now) final installment of this series, I showcase a way in which we can integrate our PowerBI dashboard with a JIRA project. This approach is completely different from what you might expect. I don’t want to put a PowerBI dashboard ontop of my JIRA task list. I want to put a JIRA task list on top of my schedule.

The purpose of the dashboard is to extract the SCHEDULE data from the scheduling tool. When variations to prior forecasts occur, or where further detail is needed, we are often constrained because pictures, running commentary and discussion about each activity is not something that resides in our schedule. However, we can use JIRA to easily capture those elements and use our PowerBI dashboard and a linking tool to integrate everything together.

The Future: ???

There are still a lot of features and extensions that I have yet to formally discuss. The next steps are likely going to be a showcase of a SQL Server backend for this data. There is a lot of information that is missed in the way this dashboard imports data (specifically past budgets). Therefore visibility into changes is restricted.

Another interesting feature is the use of saw tooth graphs when budget changes occur. I have a clear vision for how this is possible, and in a professional capacity have implemented it. To achieve this, while you won’t achieve a discontinuous graph, it will calculate your % based on a variable budget. For this, you need to setup another tab on the excel feeder which instead of tracking the earned per week per activity, it will instead track the BUDGET for each activity at each cutoff. With this data element now in your data, you just change the denominator calculation.

In general, the way in which dashboards and data are embedded into our work processes, is a field ripe for growth. It is also an endeavor that can greatly increase the visibility into project controls data and can also bring teams together using integrated tools like JIRA. As such, the future is bright and where we should always have half an eye looking.

Agile in Construction

Will Agile ideas and approaches fit the construction world – Definitely.

This does not mean I think that a lot of the tried and true practices we have developed need to change. Quite the contrary, the construction world have for decades been the pioneers for quality project management.

What has changed is the way in which people communicate and the culture we live in. Agile does have a lot of good properties in the personal communication. So I believe the construction world needs to embrace some aspects of Agile and the software tools that have been developed to support Agile management



Introduction to Agile in Construction

In this presentation, we can see that indeed many of the terms used in Agile have existed for a long time in the construction PM space. So, in many ways, we already are Agile. Thus, if you go down a path to embrace new management approaches, you first need to understand the current overlaps and also where opportunities exist.



Using JIRA to improve communication on construction projects

There are some great possibilities in using JIRA in the construction world. I do not believe a typical Agile approach fits into the project space; however, many of the ideas are sound and specifically the tools that have been built to facilitate Agile can be molded to fit the construction project space.

Specifically, this relates to the way we communicate and track the work we are performing or the work we are overseeing. Applications such as JIRA and DevOPS have capabilities that I feel are a perfect match for the construction world and we need to be looking how we can customize these new tools to really revolutionize the way construction projects are managed.


Digital Strategy (the beginnings) – by Darrin Kinney

Project Controls is the heart of every major construction project. Our teams are the ones that typically wade through information that never stops and constantly changes. Although at the core, the fundamentals of our strategy are likely the same as what everyone who manages data will encounter.

Digital Strategy for project controls is a tricky beast. We are bombarded by systems that all promise nirvana (and many can deliver nirvana for some projects). However, at the core, before we even discuss systems, we need to understand what our strategy is, and what key concepts we want to push. Below are some ideals of mine. With everything, this is a straw-man discussion. Every project will have its own culture, its own focus, its own needs. Your strategic approach has to cater to what you want from your project. Not to mention that the major companies all have quite rigorous project control plans and detailed procedures. These are great documents that do spell out our scope of services.

Project Controls is the heart of every major construction project. Our teams are the ones that typically wade through information that never stops and constantly changes. Although at the core, the fundamentals of our strategy are likely the same as what everyone who manages data will encounter.

The issues are not related to our knowledge of project controls (and project management) fundamentals. We know how to build schedule, track progress, build baselines, budgets, and track costs parsed into 1000s of potentials contracts and POs. We know how to calculate and track Earned Value, CPI, and SPI. We know change management, trends, change orders, etc. We know how to compile all the information into weekly and monthly reporting. We have the procedures and management plans.

We are the technical experts of our discipline.

However, too often, we are not able to step back and understand that the way in which we work can change, needs to change – and more importantly – the technology that is available now can be utilized to seriously disrupt the way in which we apply our technical knowledge and skills.

Below are some ideas, some concepts we can consider in everything we do to perhaps bring a more digital and smart way of operating in the new world we live in. These are not innovative in themselves, we live with these ideas already. My intent is to try to capture these ideas and through the tactical implementation of these ideas bring real innovation.

Strategy – Strategy is not Keywords

Too often, we write our strategy or integration documents and load them up with keywords and slick powerpoint. We have to embrace that we touch real things. Don’t use stick figures and cartoons  – use real live examples, get your hands dirty using the systems on your job. Understand the details. Stop writing keywords on a white board and open the application!

Digital Strategy Keywords

The real idea is to be grounded in practical things, not abstract processes.

Open your schedule, look at the activity definition that exists. Open your material management system and see if the items can be tagged with schedule activities. Look into your progress measurement sheets and determine if you can insert scheduleID to smartly update the progress in your schedule (sound like a broken record!).

Strategy – Enter data once

This is talked about by everyone, although, we have all seen it – everyone has their own spreadsheet. Every group has their own systems: SAP, Contracts, Procurement, Engineering, Cost Control, Planning: I have illustrated in the past the issue with something as standard as “where is the master contract list”. Do we really have a strategy to enter data once? If so, really delve into the data people keep on their computers in their own spreadsheets. Try as best as we can to pull key reference data out of a source system

There exist systems that can facilitate this approach and allow for integration. Although be careful and understand that integration is not strategy. The implementations of strategy will likely require integration.

Data Integration vs Digital Strategy

Enter data once is integrated into the concept of data integration. Integration is not specifically the idea that “systems talk to each other”, integration is the ability to just smartly manage your job. Unless common keys exist between systems, you can’t hope to build that integration inside a black box your digital team will build.

A good example of this is the implementation of a web based cash flow

Web Based Cashflows – Sharepoint

Strategy – Be Visual

Project Controls teams are the masters of reporting. Being visual is not about (only) creating dashboards or complex databases the feed our dashboards. Being visual is doing exactly what we already do. Stay away from data tables – Long Live Death by S-Curves!

The tabular data presentation methods we use are antiquated. Looking at an engineering progress report with 50 rows and 20 columns of various EV metrics – too often that doesn’t answer me the question of whether or not I am on plan or not. That is what I meant to be visual. Look at the questions be want answers for, the core underlying questions and FOCUS. If the question is infact “I was to see the productivity factor for 50 different areas both weekly and cum”. Perhaps choose a dot-plot. Place the values all on a graph, perhaps scale the size of the dot on the budget hours, use a horizontal axis for % and the vertical axis to show the PF. That is what I mean to “Be Visual”.

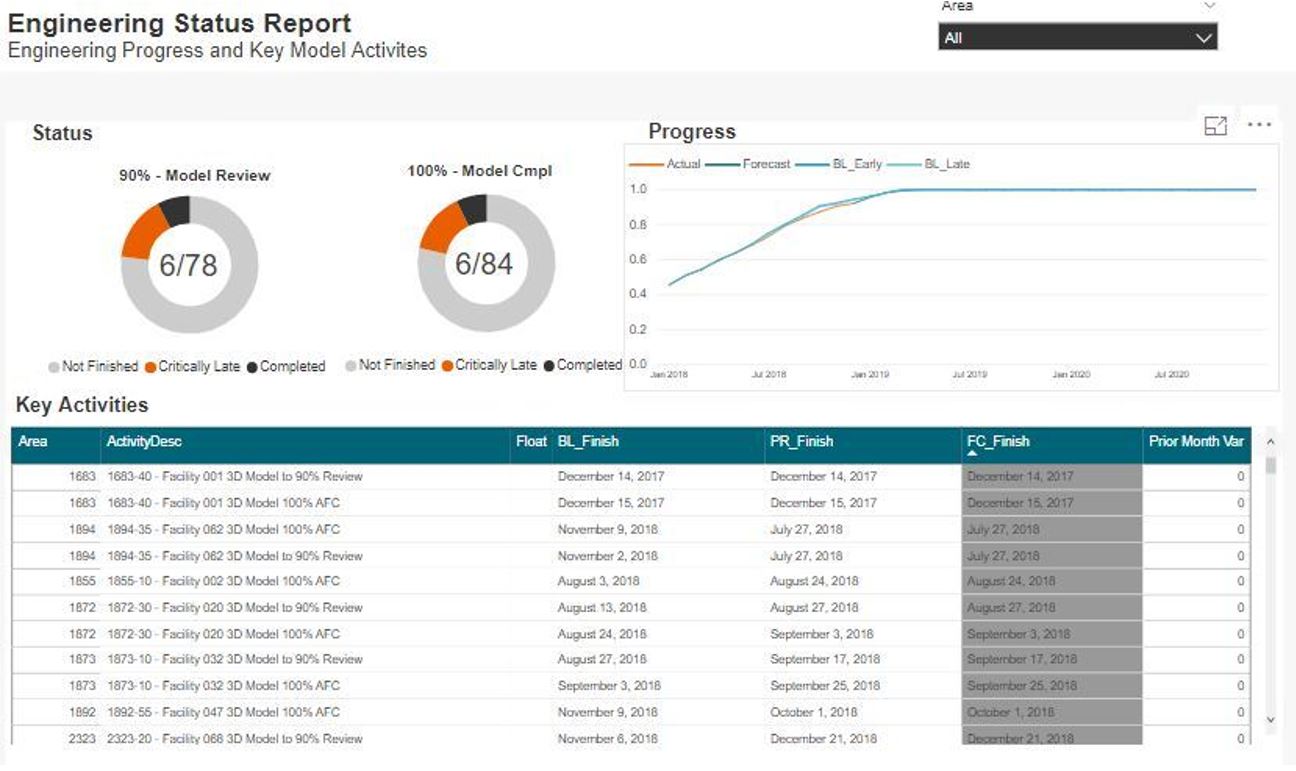

Eng12

Strategy – Push processes and data ownership to the person actually responsible, not the “function” that is responsible

Payment certificates, progress measurement reports, monthly reports: the list is never ending. We have data that originates with contractors and a multitude of sources. However, too often, the sources of information do not have access to the real database  or word/excel file used by the project. If possible, structure your data sources such that owner can manage their data.

I will likely post a few case studies about this to get people thinking of possibilities.



Strategy – Use Agile management

  • Focus on Output not Documentation
  • Respond to Change as opposed to fixation on Original Plan
  • Focus on interactions between people, not underlying systems or tools

These topics can be very disruptive: Tell a company like Fluor or Bechtel to NOT focus on plans or procedures? Good luck. However, this is a disruptive day and age and we do need to take this approach. I have worked in this business for over 20 years and honestly, in general, project controls already (generally) follows these agile fundamentals. We have plans and systems and reams of documentation, but in the end, we do (informally) have to follow these simple strategic cultural elements

What is needed here is the firm support from the management team that a proactive view of the

“what is going to happen tomorrow”

is way more valuable that the concept of

“what was planned to happen tomorrow”

The concept that

“I need this new report now”

is more relevant than

“This is the report that is defined in the PPM”

AGILE management is not able sprints or standups. Its a culture to embrace a stance that while we have general goals and objectives, the focus needs to be on what are we doing today. The reason to have daily stand ups is to have clarity on what we are doing today. The reason to have sprints is to outline near term goals. The reason we have restrospectives is to analyze the difference between what we thought we were going to do, and what we did (and more importantly how to improve the next period). This is just good project management 101! The fact someone calls it AGILE, is not relevant.

JIRA in Construction

Strategy – Allow users to LINK to key fundamental data

This is aligned with “enter data once”. But, this is a core strategic ideal that needs to be championed. We will have data housed in source systems, but have we enabled the wider project team to access this information. That is the primary idea here.

Is information shared by way of excel exports that are distributed via email to various people at various times? Or, do we have a project where information is open and accessible. The latter is what our strategic approach to everything should be.



Strategy – Facilitate live real time data

Ultimately you will need some sort of approach to cadence and integration. Will we be using real time data, will we instead focus on cutoffs.

This can if we really delve deeper into what this really means, be very disruptive. With real time data, the need for monthly reporting is useless, the need for weekly reporting – is useless. Reporting is a natural output 24/7 from the way we operate. This cultural approach to construction management is where I think we need to go to be hyper reactive to change.



Strategy – Be Hyper Reactive

As I mention above, we want to have a core ideal that allows us to change course immediately when required. We have submitted the same schedule and cost reports every month – WHY? Do not be afraid to change things up, support a workplace where the team can be hyper reactive to respond to everything.

For schedule management, this requires the approach to insert activities into the schedule with daily vigor to reflect what is happening today.

For cost management this requires detailed ticket management approach to our tasks to allow visibility into everything we do 24/7



Conclusion – Do not be afraid to push boundaries

This list above is again just a beginning of a discussion. These are discussion topics that are occurring in every company around the world.

As we head into the future, we have an entire generation of new employees who are not afraid of technology. Quite the contrary, the newer generations of people will feel more comfortable updating a web form vs updating a word file. They will feel more comfortable posting progress updates to a social media site vs writing a daily report. They will be more comfortable making mistakes, and fixing them.

The dashboard craze is here to stay. The use of dashboards and the approach needed to create PowerBI or other application based analytics tick many of the strategic elements I have outlined here.

In the end – do not be afraid to push boundaries with your approach to construction management.
